Project

CONSTRUCTION, MAINTENANCE, REHABILITATION AND OPERATION OF THE "TEPIC-COMPOSTELA HIGHWAY" AND SEGMENT 2, "COMPOSTELA-LAS VARAS" SECTION OF THE "JALA-COMPOSTELA-LAS VARAS highway AND RAMAL TO COMPOSTELA", IN THE STATE OF NAYARIT.

Sector: Transport


Last Revision

November 10, 2025

Short Name of the Project:
0908 C-MRO "Tepic-Compostela Highway" and "Jala-Compostela-Las Varas Highway and Branch to Compostela", "Compostela-Las Varas" section
Type of Investment:
Brownfield
Subsector:
Highways / bridges
Asset (s):
 Highway 55.40 KM
Contract Currency:
Mexican Pesos MXN
Estimated Investment MXN:

4,914,797,021

Estimated Investment USD:

254,652,695

Banobras, Fonadin involvement Banobras/Fonadin involvement

Exchange rate (USD/MXN) used by the Ministry of Finance for the economic plan 2026: $ 19.3
Contract Scope:
  Construction,  Operation,  Maintenance

DESCRIPTION

The project consists of the construction, maintenance, rehabilitation and operation under performance standards of 55.4 km of highways:

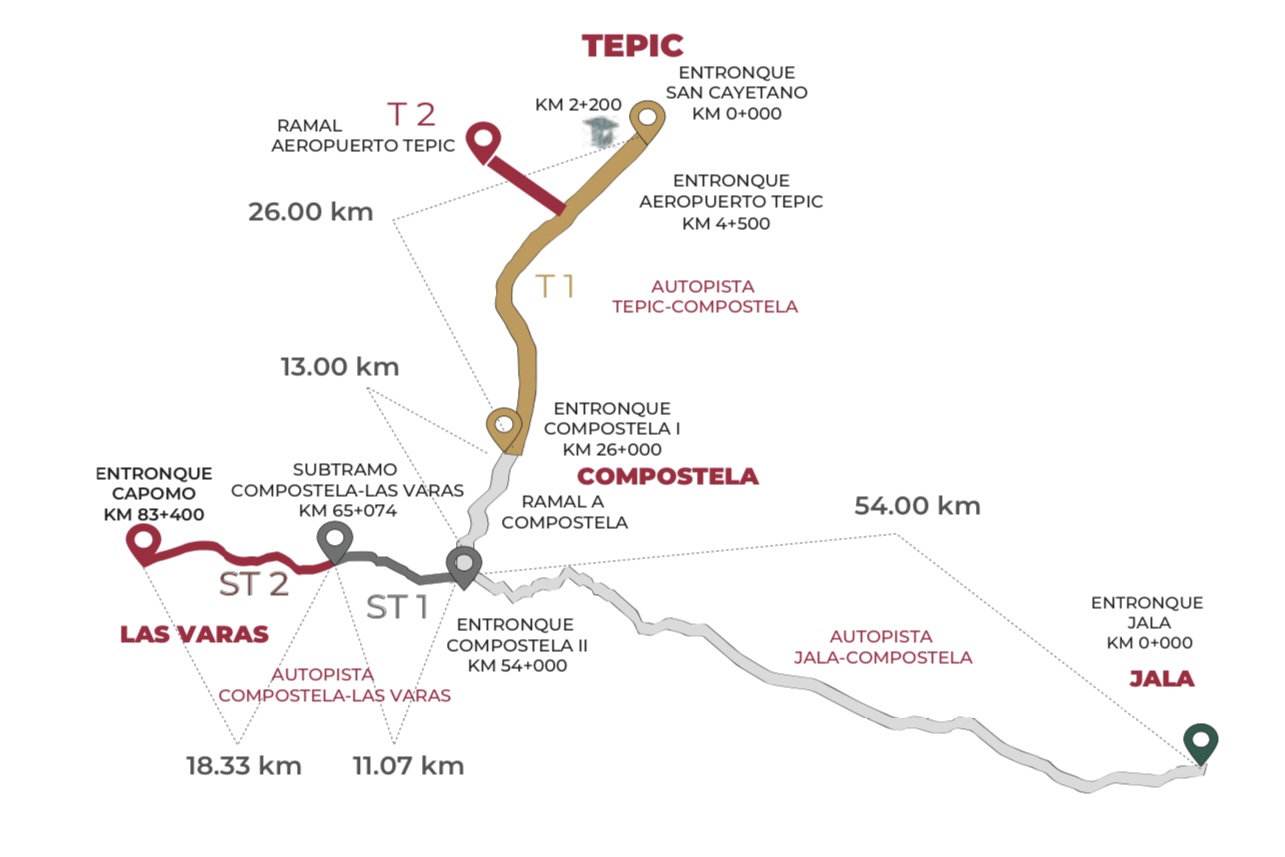

i) Construction, maintenance, rehabilitation and operation of the "Tepic-Compostela Highway", approximately 26 km type A2
ii) Construction (continuation and completion of construction), maintenance, rehabilitation and operation of sub-segment B of segment 2 "Compostela-Las Varas", of the "Jala-Compostela-Las Varas Highway and Branch to Compostela", includes the Junction El Capomo, approximately 18.3 km type A4, from km 65+074 to km 83+400 of said highway

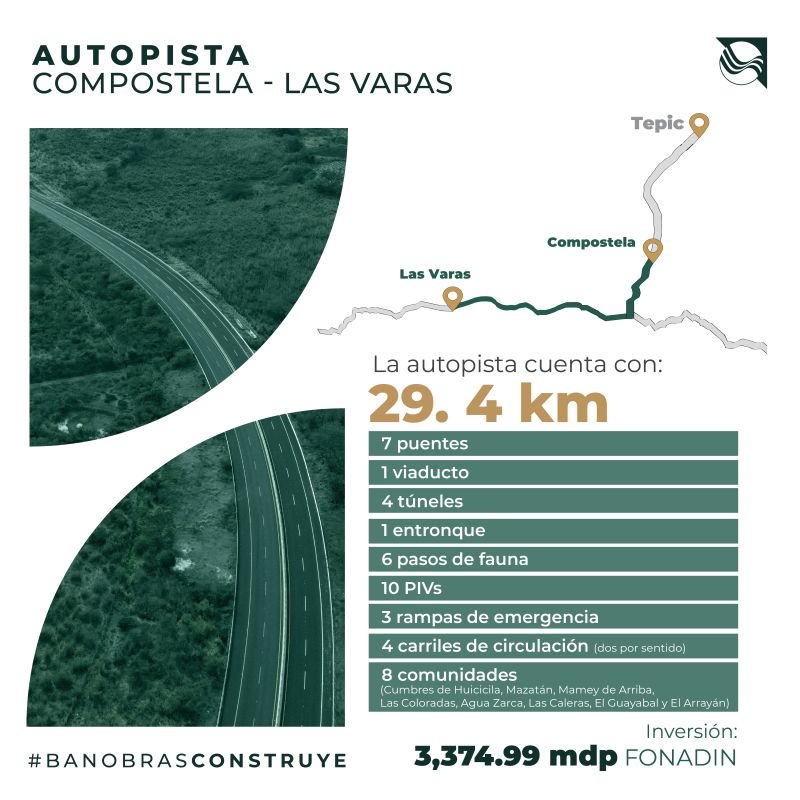

iii) Maintenance, rehabilitation and operation of sub-segment A of segment 2 "Compostela-Las Varas", of the "Jala-Compostela-Las Varas Highway and Ramal to Compostela", approximately 11 km type A4, from km 54+000 to km 65+074 of said highway.

The Tepic-Compostela highway is under construction, and the construction of the Tepic Airport Branch will be incorporated, with a length of 2.4 km, and an estimated investment of 293 million pesos.

These highways belong to the concession title granted by the Ministry of Infrastructure, Communications and Transportation to the National Infrastructure Fund.

LEGAL AND FINANCIAL STRUCTURE

Type of Project
  Public / Private
Type of Contract
  Federal PPP
Term
10 years
Selection Process
International Open Tender
Payment Source
Project revenues / Rate
The highway concessionaire will pay the developer a consideration for the construction, maintenance, rehabilitation and operation of the highways.

STATUS

Stage
  Operation
Substage
  < 5 years of operation
RELEVANT DATES
Ministry of Finance Registration or equivalent January 28, 2022
Request for proposals/Announcement February 03, 2022
Proposals Reception April 28, 2022
Ruling June 16, 2022
Contract Signing July 13, 2022
Execution/Construction Starting Date August 10, 2022
Operation Starting Date November 08, 2025
Term of the Contract 2032
Contractor
Mota-Engil México
Major Contractor’s Shareholders
Mota-Engil

GEOLOCATION

State(s)
Nayarit

SPONSOR

Responsive image
Entity
BANOBRAS / Trust FONADIN
Department
Dirección General Adjunta Fiduciaria
Contact
Sergio Enrique Sánchez Rivera
E-mail
sergio.sanchez@banobras.gob.mx

SUSTAINABLE INFORMATION

PROJECT’S SUSTAINABILITY SUMMARY

The project's objective is to build the Tepic-Las Varas highway to connect it with the Jala-Compostela-Bahía de Banderas highway, thereby improving Tepic's connection with the most important tourist area in the state of Nayarit. Likewise, it seeks to strengthen the connectivity between Compostela and Tepic, by improving transfer times and the safety of people and goods.

* This summary was prepared based on the methodological framework defined by the Inter-American Development Bank (IDB) in the document entitled: “Attributes and Framework for Sustainable Infrastructure”, which is You can check Here.

Additionally, a brief explanation of the methodology and a summary of the questions applied can be consulted in this Document.

DOCUMENTS USED:

- Circular Letter, Modification of Base 32
- Opening Act C-MRO Tepic-Compostela
- Deferral of Event Dates
- Modification of Date of the Act of Reading of the Opinion
- Technical Opinion Reading Minutes
- Minutes of Reading of Economic Offers and Judgment
- Circular, Deferral of clarification meeting dates
- Minutes Board of Clarifications
- Annex 1 Minutes of the Clarifications Meeting
- Circular, CMRO
- Circular, Annex "Consortium Agreement Format" is modified
- Presentation Non-Binding C-MRO
- Obtaining the Preliminary Registration of Contestants
- Act of visit to the site
- Call MRO 2022
- MIA 18NA2020V0035
- Resolution 18NA2020V0035
- Abstract 18NA2022VD097
- MIA 18NA2022VD097
- DOF Contest
- MSE Profile
- Financial Report Q3 2022
- Annual Report 2021 BMV
- Mota Engil Website
- Sustainability Report 2020
- GRI 2021
- Corporate Governance
- Code of Ethics and Business Conduct
- Equality and Non-Discrimination Plan
- Irregularity Communication Procedure
- Integrity and Compliance Program
- Social Sustainability
- Definitive BMV Prospect
- Economic-Financial Aspects
- Payment Mechanism Model
- EIA
- Evaluation Criteria
- Resolution MIA

ADDITIONAL INFORMATION

Line
Source
Diario Oficial de la Federación
Description
A Constitutional Government of the United Mexican States Body, which has the function of publishing in the national territory: laws, regulations, agreements, circulars, orders and other acts issued by the powers of the Federation.
Line
Source
Fonadin
Description
National Infrastructure Fund that supports the development of communications, transport, water, environmental and tourism sectors by providing grants, venture capital, subordinated debt, credit and guarantees for the design and execution of high impact infrastructure projects.
Line
Source
Secretaría de Medio Ambiente y Recursos Naturales
Description
Federal government entity and sectorial authority responsible for establishing the necessary criteria and instruments to guarantee the protection, preservation, and use of natural resources, by developing an environmental policy that ensures sustainable growth.
Portfolio ID or Key
18NA2020V0035
Tepic-Compostela Permits, 2020
Portfolio ID or Key
18NA2022VD097
Tepic-Compostela Permits, 2022
Line
Source
BANOBRAS
Description
Banco Nacional de Obras y Servicios Públicos (BANOBRAS) is a development bank that makes the development of infrastructure projects with high social profitability possible, by providing long term funding to private developers, and state and municipal governments, and by promoting the participation of the private sector and commercial banks.

MULTIMEDIA

Gallery

REMARKS

The construction of subsegment A of segment 2 of the Compostela-Las Varas section was completed in May 2023.
On Mar. 27, 2024, operation of the Compostela-Las Varas section began, that is, from km 54+000 to 83+400 (Subsegments A and B).
