Bridges and viaducts

The description of the works is based on official announcements, the Compras MX website, the Investment Unit’s records, and the Semarnat Gazette.
FOLLOW THE PROJECT

Follow the Project

Leave your e-mail to receive updates on this Project.

×
7
=

I have read and I accept the Privacy Notice

Sector: Transport

Subsectors: Highways / bridges

Estimated Investment: MXN $13,770,000,000

Description:

The projects involve the construction of bridges and interchanges with a total length of 15.8 km as part of the National Highway Infrastructure Program to be implemented between 2025 and 2030.

The tenders for the various bridges and viaducts can be consulted in detail once they are published and identified.

Menu
  • ALAMEDA ORIENTE
  • AMADO NERVO
  • ARCO NORTE
  • ARCO SUR
  • BARRIO V
  • COATZACOALCOS
  • DE LOS PATOS
  • DEL TORO
  • EL CHICAL
  • FONATUR ROUNDABOUT
  • GEOLOGICAL FAULT
  • JOJUTLA BRIDGE
  • LA FLECHITA
  • LA PRESA BRIDGE
  • LAS TUNAS
  • LUIS DONALDO C.
  • MANZANILLO ENTRANCE
  • PÉREZ ESCOBOSA
  • PORT OF VERACRUZ
  • SANTA ANA VIADUCT
  • UAEM

Sponsor

Secretaría de Infraestructura Comunicaciones y Transportes

Entity
Secretaría de Infraestructura, Comunicaciones y Transportes
Department
Dirección General de Carreteras
Contact
Ricardo Abel Santiago Vicuña
E-mail
ricardo.santiago@sct.gob.mx

GEOLOCATION

Ver en pantalla completa

Press Releases

Fonatur Roundabout, in BCS, will benefit 2.6 million tourists who visit the region each year: SICT

Fonatur Roundabout, in BCS, will benefit 2.6 million tourists who visit the region each year: SICT

• The 1.5 km long project will make communication more efficient in the tourist corridor from Cabo San Lucas to San José del Cabo and the San José del Cabo Airport. • The project includes a pedestrian bridge, walkways, and Pedestrian sidewalks, bicycle lanes, public lighting, and traffic lights

Ministry of Communications and Transportation | June 8, 2025 | Press Release

SICT will build 21 bridges and interchanges in 10 regions of the country

SICT will build 21 bridges and interchanges in 10 regions of the country

They will be built in Mexico City, Colima, Veracruz, Tlaxcala, Nayarit, Sinaloa, Morelos, Baja California Sur, Querétaro, and Quintana Roo

Secretary of Communications and Transportation | June 3, 2025 | Press Release

Fonatur Roundabout Vehicle Access Will Benefit 351,000 Residents of Baja California Sur

Fonatur Roundabout Vehicle Access Will Benefit 351,000 Residents of Baja California Sur

• An investment of 450 million pesos will be allocated and it will be completed in 2026 • During its construction, 3,805 jobs

Secretary of Communications and Transportation | May 18, 2025 | Press Release

Esteva Medina Announces Start of Construction on the Fonatur Roundabout Vehicle Access in Baja California Sur

Esteva Medina Announces Start of Construction on the Fonatur Roundabout Vehicle Access in Baja California Sur

He accompanied President Claudia Sheinbaum Pardo on a working tour of this state and said that the road will benefit 351,000 residents. It will be completed in June 2026, with an investment of 450 million pesos.

Ministry of Communications and Transportation | May 17, 2025 | Press Release

The Highway Infrastructure Program advances with an investment of 56.549 billion pesos in 2025 and the creation of 162,000 jobs.

The Highway Infrastructure Program advances with an investment of 56.549 billion pesos in 2025 and the creation of 162,000 jobs.

The President of Mexico emphasized that, with the Fourth Transformation, public resources are being reinvested in public works for the benefit of all Mexicans. These include 109 km of continuity works; 2,220 km of 10 priority axes; 16 km of bridges and road distributions; 904 km of Lázaro Cárdenas del Río Plan works; the Guerrero Highway Program; 2,107 km of artisanal roads; 48,653 km of routine maintenance actions; and 9,472 km of periodic maintenance.

Ministry of Communications and Transportation | May 7, 2025 | Press Release

Modernization of the Jojutla Bridge will improve the lives of 22,000 Morelos residents

Modernization of the Jojutla Bridge will improve the lives of 22,000 Morelos residents

The new structure will be elevated to prevent flooding and ensure the safety of the population.

Ministry of Communications and Transportation | May 2, 2025 | Press Release

Announcement of the construction of access to the Port of Veracruz and a bypass in Colima

Announcement of the construction of access to the Port of Veracruz and a bypass in Colima

Both states are economically important for the country and the regions due to their tourism and port activities. • Access to the Port of Veracruz will be part of the federal highway Mex-140 Xalapa-Veracruz; the “Arco Norte” bypass will be installed in the city of Colima.

Ministry of Communications and Transportation | April 1, 2025 | Press Release

With an investment of more than 11,847 million pesos, the SICT will build 15.8 km of bridges and interchanges.

With an investment of more than 11,847 million pesos, the SICT will build 15.8 km of bridges and interchanges.

These works will be carried out in Baja California Sur, Mexico City/State of Mexico, Colima, Morelos, Nayarit, Querétaro, Quintana Roo, Sinaloa, Tlaxcala and Veracruz.

Ministry of Communications and Transportation | March 24, 2025 | Press Release

Videos

#MañaneraDelPueblo from the National Palace. Wednesday, June 4, 2025

#MañaneraDelPueblo from the National Palace. Wednesday, June 4, 2025

  • Advances, Road Infrastructure

#MañaneraDelPueblo from the National Palace. Wednesday, May 7, 2025

#MañaneraDelPueblo from the National Palace. Wednesday, May 7, 2025

  • Advances, Road Infrastructure

#MañaneraDelPueblo from the National Palace. Wednesday, February 26, 2025

#MañaneraDelPueblo from the National Palace. Wednesday, February 26, 2025

  • National Road Infrastructure Program 2025-2030

Two Alameda Oriente Bridges

Compras MX

LO-09-210-009000999-T-150-2025
Sitio web

Comprehensive project that includes engineering studies, executive design and the construction of vehicular bridges 1 and 2 in Alameda Oriente, interconnection with federal highway MEX 15, Mexico – Puebla km 9+000 and highway MEX 136D Peñón – Texcoco km 0+000, on the borders of the State of Mexico and Mexico City.

  • Announcement

    May 6, 2025

  • Proposals Reception

    June 10, 2025

  • Ruling

    June 13, 2025

  • Contract Starting Date

    June 14, 2025

  • Execution Term

    850 calendar days

Contractor: CEMEX Concretos, S.A. de C.V.

Investment Unit of the Ministry of Finance and Public Credit

25096350003

Construction of two bridges in Alameda Oriente, one 705 meters long and the other 504 meters long.

Amado Nervo Bridge

Compras MX

LO-09-210-009000999-T-113-2025
Website

Construction of the bridge and its access points, the “Ameca River Bridge,” located at km 15+680 of the Avenida Federación road in the municipalities of Bahía de Banderas and Puerto Vallarta, in the states of Nayarit and Jalisco.

  • Announcement

    Apr. 23, 2025

  • Proposals Reception

    June 23, 2025

  • Ruling

    July 1, 2025

  • Contract Starting Date

    July 7, 2025

  • Execution Term

    546 natural days

Contractor: Regiomontana de Construcción y Servicios S.A.P.I. de C.V.; Jaguar Ingenieros Constructores, S.A. de C.V. & JYR Ingenieros Constructores S.A. de C.V.

Semarnat Permits

18NA2025V0003
Website

Construction of the Ameca River interstate bridge, over the Ameca River and Federación Avenue, in the states of Jalisco and Nayarit.

Investment Unit of the Ministry of Finance and Public Credit

25096340001

Amado Nervo Bridge (Federación) The project consists of a new route that will allow communication between Puerto Vallarta and Bahía de Banderas through the construction of a bridge over the Ameca River and its accesses with Avenida Federación. The bridge will be 800.4 meters long, which will accommodate 4 lanes, 2 in each direction of traffic of 3.5 meters, side shoulders of 1.50 meters and a central barrier with a width of 1 meter, for a total width of 20.0 meters. In addition, the construction of 1.55 km of access roads is proposed, on the Puerto Vallarta side, the East access (from km 14+360 to km 15+275), and on the Bahía de Banderas side, the West access (from km 16+075 to km 16+716

“Arco Norte” Vehicular Overpass

Compras MX

LO-09-210-009000999-N-80-2025
Sitio web

Construction of the “Arco Norte” vehicular overpass, which includes earthworks, mechanically stabilized walls, drainage works, reinforced and prestressed hydraulic concrete structures, paving, horizontal and vertical signage, as well as the relocation of induced works, and reconstruction of side streets, located within km 2+950 to km 4+100 of the Arco Norte in the city of Colima, State of Colima.

  • Announcement

    Apr. 1st, 2025

  • Proposals Reception

    May 29, 2025

  • Ruling

    June 5, 2025

  • Contract Starting Date

    June 11, 2025

  • Plazo de ejecución

    365 calendar days

Contractor: IDEVVSA Construcciones, S.A. de C.V. and Consorcio Continental de Infraestructura, S.A. de C.V.

Investment Unit of the Ministry of Finance and Public Credit

25096260002
Website

Website in Spanish

Construction of the Arco Norte Overpass. Construction of an overpass (PSV) with a cross-section type A6s, featuring three traffic lanes in each direction, each 3.5 meters wide, divided into two carriageways with a total width of 25.30 meters each, separated by 0.70 meters, and including a ground-level roundabout.

“Arco Sur” Railway Overpass

Compras MX

LO-09-210-009000999-T-100-2025
Website

Construction of the “Arco Sur” railway overpass, which includes earthworks, mechanically stabilized walls, drainage works, reinforced and prestressed hydraulic concrete structures, paving, horizontal and vertical signage, as well as the relocation of induced works, and reconstruction of side streets, located within km 0+224 to km 1+370 of the Arco Sur in the city of Colima, State of Colima.

  • Announcement

    Apr. 4, 2025

  • Proposals Reception

    June 18, 2025

  • Ruling

    June 26, 2025

  • Contract Starting Date

    July 04, 2025

  • Execution Term

    365 natural days

Contractor: Coconal, S.A.P.I. de C.V.

Investment Unit of the Ministry of Finance and Public Credit

25096260001
Website

Construcción del Paso Superior Vehicular Arco Sur.

Barrio V Bridge

  • State: Colima
  • Length: 0.7 km
  • Execution: 1 año
  • Investment: 200 mdp

Coatzacoalcos I Bridge

  • State: Veracruz
  • Length: 2.2 km
  • Execution: 3 years
  • Investment: 4,400 mdp

Two bridges on Av. de Los Patos

  • State: Queretaro
  • Length: 1.2 km
  • Execution: 2 years
  • Investment: 490 mdp

Paso del Toro Interchange

  • State: Veracruz
  • Length: .35 km
  • Execution: 1 year
  • Investment: 350 mdp

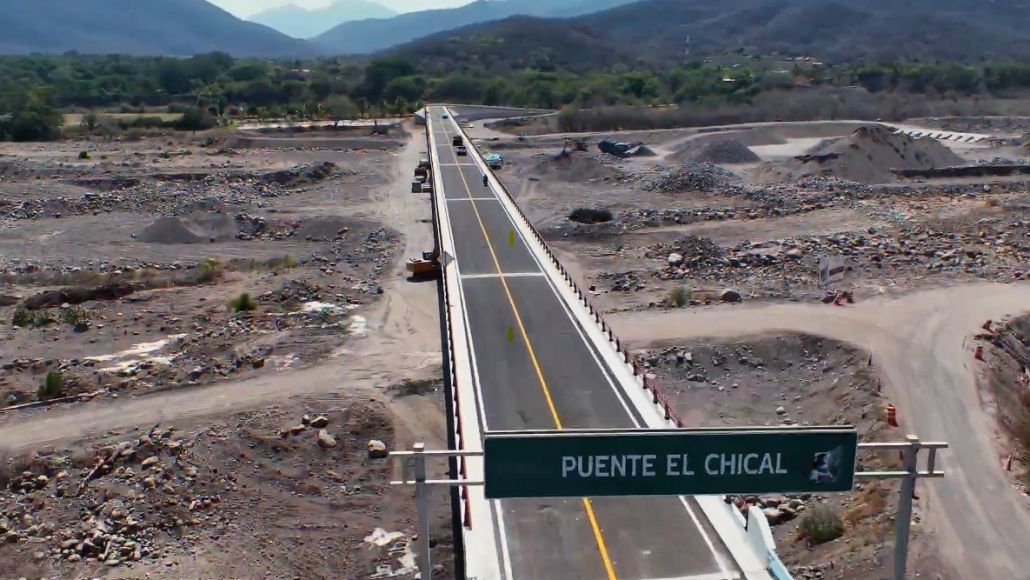

Reconstruction of El Chical

Compras MX

LO-09-210-009000999-N-306-2025
Website

Construction of the “El Chical” bridge, which includes earthworks, channel cleaning, reinforced and prestressed hydraulic concrete structures, paving, and horizontal and vertical signage. It is located between km 5+000 and km 5+765 of the Colima/Coquimatlán – El Chical Junction Highway, in the municipality of Coquimatlán, state of Colima.

  • Announcement

    June 26, 2025

  • Proposals Reception

    July 9, 2025

  • Ruling

    July 14, 2025

  • Contract Starting Date

    July 16, 2025

  • Execution Term

    365 natural days

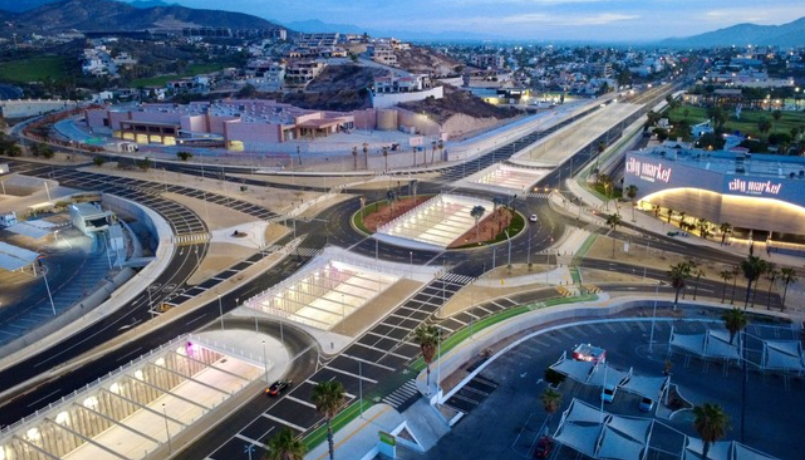

Fonatur Roundabout

Compras MX

LO-09-210-009000999-T-75-2025
Website

Construction of a 4-lane underpass, 2 in each direction of traffic, and the geometric adaptation of the Fonatur Roundabout, located at km 30+300 of the Cabo San Lucas – La Paz highway, including: retaining walls, structures, drainage works, complementary works, earthworks, asphalt concrete pavements, vertical and horizontal signage.

  • Announcement

    Mar. 21, 2025

  • Proposals Reception

    Apr. 2nd, 2025

  • Ruling

    Apr. 24, 2025

  • Contract Starting Date

    May 2nd, 2025

  • Execution Term

    410 natural days

Contractor: Triturados y Asfaltos de Atlacomulco S.A. de C.V., Placosa S.A. de C.V. and Infraestructura y Desarrollo Integral DICSSA, S.A. de C.V.

Bridge to overcome geological fault

  • State: Quintana Roo
  • Length: .33 km
  • Execution: 1 year
  • Investment: 300 mdp

Jojutla Bridge

Puente Jojutla

Compras MX

LO-09-210-009000999-N-28-2025
Website

Modernization of the Jojutla Bridge, from 1 to 2 lanes, over the Yautepec River, located at km 1+600 of the Jojutla – Valle de Vázquez – Chinameca highway, in the municipality of Jojutla, Morelos.

  • Announcement

    Feb. 20, 2025

  • Proposals Reception

    Mar. 12, 2025

  • Ruling

    Mar. 21, 2025

  • Contract Starting Date

    Mar. 25, 2025

  • Execution Term

    261 natural days

Contractor: Consultoría y Construcciones SIBAMSA, S.A. de C.V. and Corporativo Constructor IOBSA, S.A. de C.V.

Semarnat Permits

17MO2025V0001
Website

Jojutla Bridge located at km 0+500 on the Jojutla – Chinameca road, with a length of 40.0 m, in the municipality of Tlaquiltenango, State of Morelos.

Budget transparency

25096370001

Construcción del Puente Vehicular Jojutla.

La Flechita

Vehicular overpass at the “La Flechita” port area

  • State: Colima
  • Length: 0.7 km
  • Execution: 1 year
  • Investment: 200 mdp

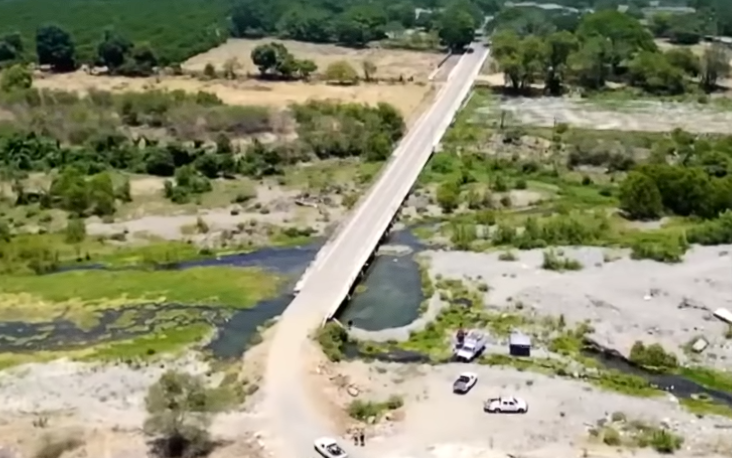

La Presa Bridge

Compras MX

LO-09-210-009000999-N-307-2025
Website

Construction of the “La Presa” bridge, which includes earthworks, channel clearing, reinforced and prestressed hydraulic concrete structures, paving, and horizontal and vertical signage. The bridge is located between km 2+900 and km 3+300 of the Ixtlauacán – La Presa highway, in the municipality of Ixtlauacán, in the state of Colima.

  • Announcement

    June 26, 2025

  • Proposals Reception

    July 9, 2025

  • Ruling

    July 14, 2025

  • Contract Starting Date

    July 16, 2025

  • Execution Term

    365 natural days

Semarnat Permits

06CL2025V0016
Website

Environmental Impact Statement in its Particular Modality of the “La Presa” Bridge, located at Km. 3+355, on the Ixtlahuacán – Las Presas road, with a length of 90.0 m, in the State of Colima.

Reconstruction of Las Tunas

  • State: Colima
  • Length: 0.2 km
  • Execution: 2 years
  • Starting Date: June 27, 2025

Luis Donaldo Colosio

Railway overpass (Luis Donaldo Colosio Avenue)

  • State: Nayarit
  • Length: 0.4 km
  • Execution: 1 year
  • Investment: 250 mdp

Main entrance to Manzanillo

Railway overpass, main entrance to Manzanillo (Tapeixtles)

  • State: Colima
  • Length: 0.8 km
  • Execution: 1 year
  • Investment: 300 mdp

Vehicular Overpass Av. Pérez Escobosa

Compras MX

LO-09-210-009000999-T-366-2025
Website

Construction of the Av. Pérez Escobosa PSV, located at km 0+770 of the Mazatlán – Culiacán highway, through the construction of earthworks, drainage works, hydraulic concrete paving, structures, complementary works, and signage in the municipality of Mazatlán, in the State of Sinaloa.

  • Announcement

    July 7, 2025

  • Proposals Reception

    July 24, 2025

  • Ruling

    July 30, 2025

Semarnat Permits

25SI2025V0005
Website

Construction of a vehicular overpass on Mexico City-15 at the intersection with Óscar Pérez Escobosa Avenue, in the city of Mazatlán, Sinaloa.

Investment Unit of the Ministry of Finance and Public Credit

25096450001

Access to the Port of Veracruz

Acceso al puerto de Veracruz

Compras MX

LO-09-210-009000999-T-81-2025
Website

Construction of the access road interchange to the port of Veracruz at km 94+360, including side streets, through the construction of earthworks, drainage works, asphalt concrete paving, complementary works, vertical, horizontal and institutional signage, of the federal highway MEX-140: Xalapa – Veracruz, section: Santa Rita – Tamsa, sub-section: km 93+350 to km 95+320, in the State of Veracruz.

  • Announcement

    Apr. 1st, 2025

  • Proposals Reception

    June 6, 2025

  • Ruling

    June 19, 2025

  • Contract Starting Date

    June 24, 2025

  • Execution Term

    458 calendar days

Contractor: ALZ Construcciones, S.A. de C.V.

Compras MX

LO-09-210-009000999-N-396-2025
Website

“Expansion of buffer lanes on Federal Highway MEX-140: Xalapa – Veracruz, section: Tamsa – Paso San Juan, sub-section: from km 88+080 to km 88+680, over a length of 0.610 km, through the construction of earthworks, complementary works, paving and signage; in the state of Veracruz.”

  • Announcement

    July. 1st, 2025

  • Proposals Reception

    Aug. 22, 2025

  • Ruling

    Sept. 9, 2025

  • Contract Starting Date

    Sept. 17, 2025

  • Execution Term

    110 calendar days

Contractor: Grupo Comercial y Constructor Agua Blanca S.A. de C.V.

Semarnat Permits

30VE2025V0016
Website

Preparation of the regional environmental impact statement for the construction of the access road interchange to the Port of Veracruz (including the Santa Rita interchange and the Tamsa viaduct), in the state of Veracruz.

Investment Unit of the Ministry of Finance and Public Credit

25096500001

Access Road Interchange to the Port of Veracruz, TAMSA Viaduct.
The project consists of the construction of a road interchange located at the intersection of Federal Highway MEX-140 Xalapa – Veracruz and the Port Boulevard. It is designed to provide uninterrupted traffic flow for long-distance vehicles traveling along the federal highway through a viaduct measuring 872.44 meters in length and 19.8 meters in width. The cross-section will accommodate four lanes—two in each direction—each 3.5 meters wide, with an outer shoulder of 1.5 meters, an inner shoulder of 0.5 meters, a 0.4-meter parapet, and a 1.0-meter central dividing barrier.

Santa Ana Viaduct

Compras MX

LO-09-210-009000999-T-76-2025
Website

Construction of the Santa Ana Viaduct, from km 29+420 to km 30+028, over the intersection of Federal Highway No. 121 Puebla-Belén, whose works consist of the construction of earthworks, drainage works, structures, pavements, induced works, traffic lights, signage and lighting, in the State of Tlaxcala.

  • Announcement

    Apr. 23, 2025

  • Proposals Reception

    June 23, 2025

  • Ruling

    July 15, 2025

  • Contract Starting Date

    July 16, 2025

  • Execution Term

    457 calendar days

Investment Unit of the Ministry of Finance and Public Credit

25096490001

UAEM Bridge

Vehicle Access Bridge to the Autonomous University of the State of Morelos

  • State: Morelos
  • Length: 1 km
  • Execution: 1 year
  • Investment: 350 mdp

Quick Access

  • Core Partners
  • Policies
  • News
  • Contact
  • FAQ´s

Mexico Projects Hub

  • Why Mexico?
  • Projects Hub
  • How to Invest?
  • Knowledge Hub
  • About
D.R. © Banco Nacional de Obras y Servicios Públicos, S.N.C., Ciudad de México, 2025. - Enfold Child Theme by Kriesi
  • Site Map
  • Privacy Notice
  • Terms and Conditions
Trámites Gobierno Buscar
Scroll to top
